Tutorial Steps for Operation
#work
#robot

Putty robot Manual

  1. Connect supply hose and air hose to the robot
  2. Insert water into the material supply machine
  3. Connect power source
  4. Turn ON for the machine (note: make sure the air valve is turn off)
  5. Turn ON pump machine and manual control
  6. Knob the air pressure to about 150kP
  7. Knob and test the water whether the machine is functioning well
  8. Turn off manual control
  9. Set robot into standby mode and test the water deposit normally
  10. Deposit all the water from the supply machine and insert putty
  11. Reassure step 6 to 10 is same for putty
  12. Connect and turn on the air valve
  13. Move to operation area and start

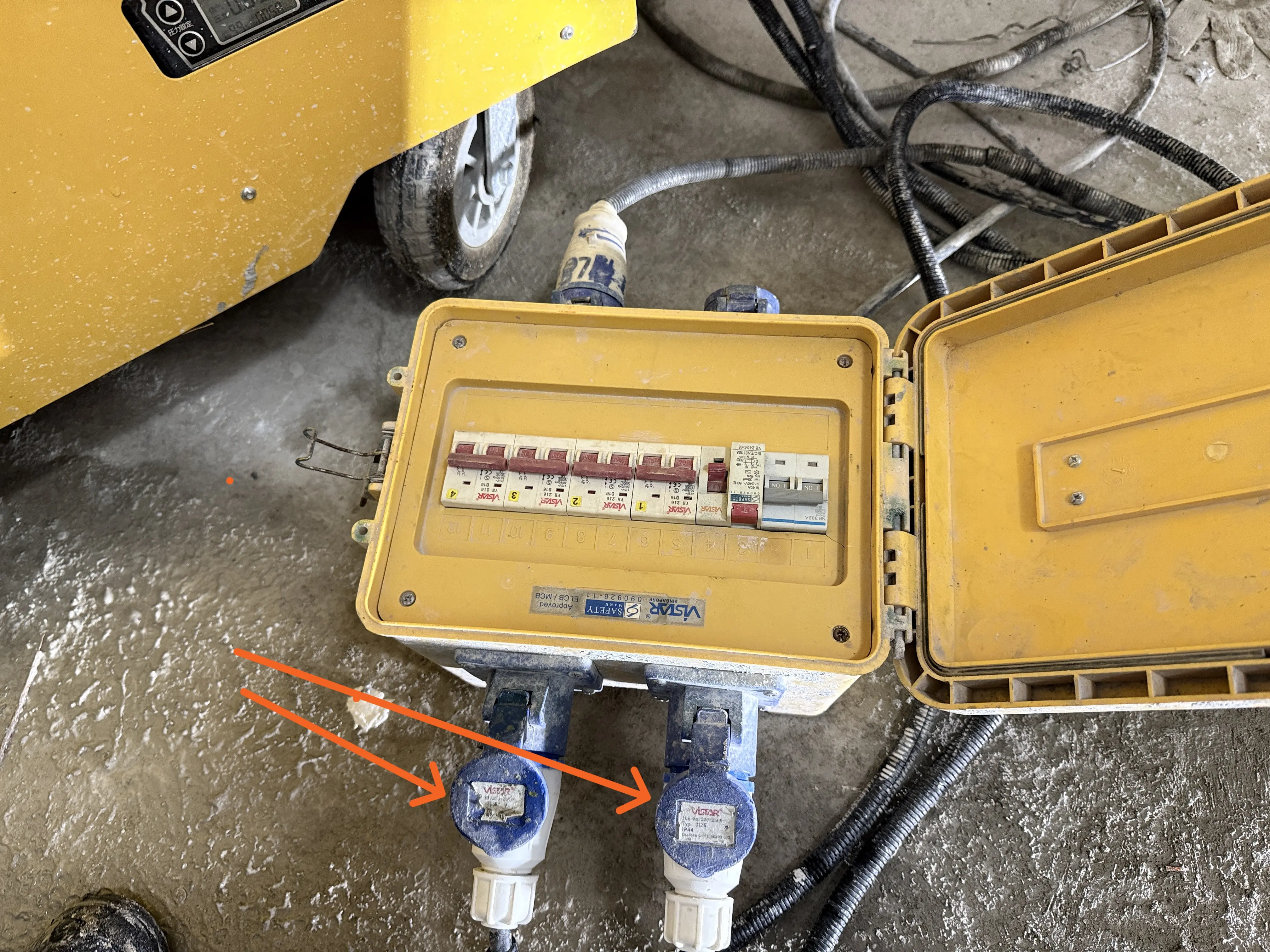

Power Supply Requirement for Material Feeder

|671x503

Initialization of the Robot

https://youtu.be/h3cFFBE334I

[[]]

Initialization Navigation guide on tablet Application

https://youtu.be/RIarFAavDLk

After ensure successful initialization (Horizontal Head)

fixing the scraper head in place

Testing mode confirmation

This testing mode is the same process as normal operation, but before starting the operator will have to choose TESTING.
|548x455

Tablet Application Navigation (Normal Mode)

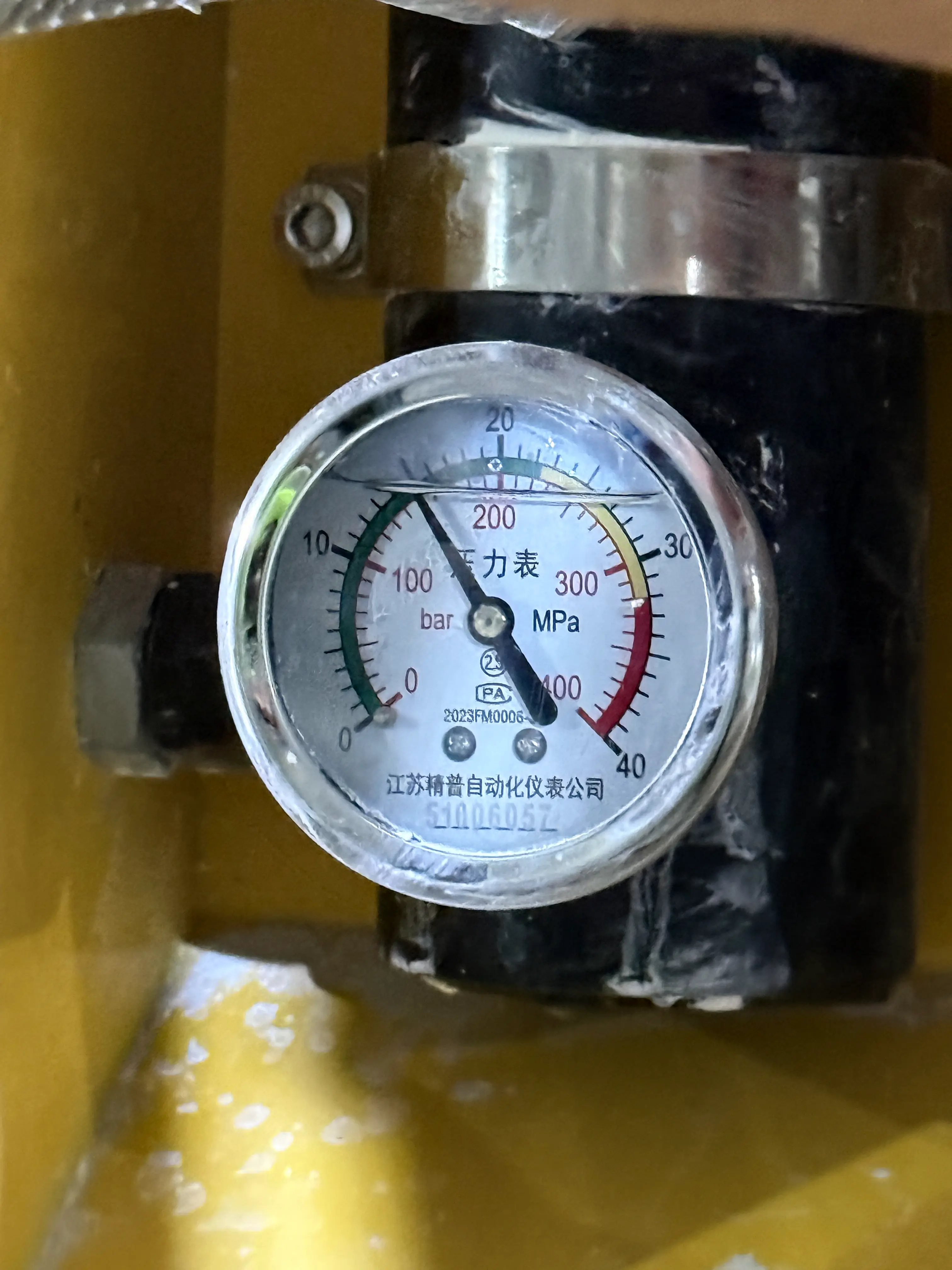

Knob air pressure to about 150kP

|697|318x364

Positioning the robot arm down for cleaning/ Discharge testing

Cleaning/ Discharge Testing of (water/putty) on material feeder and robot

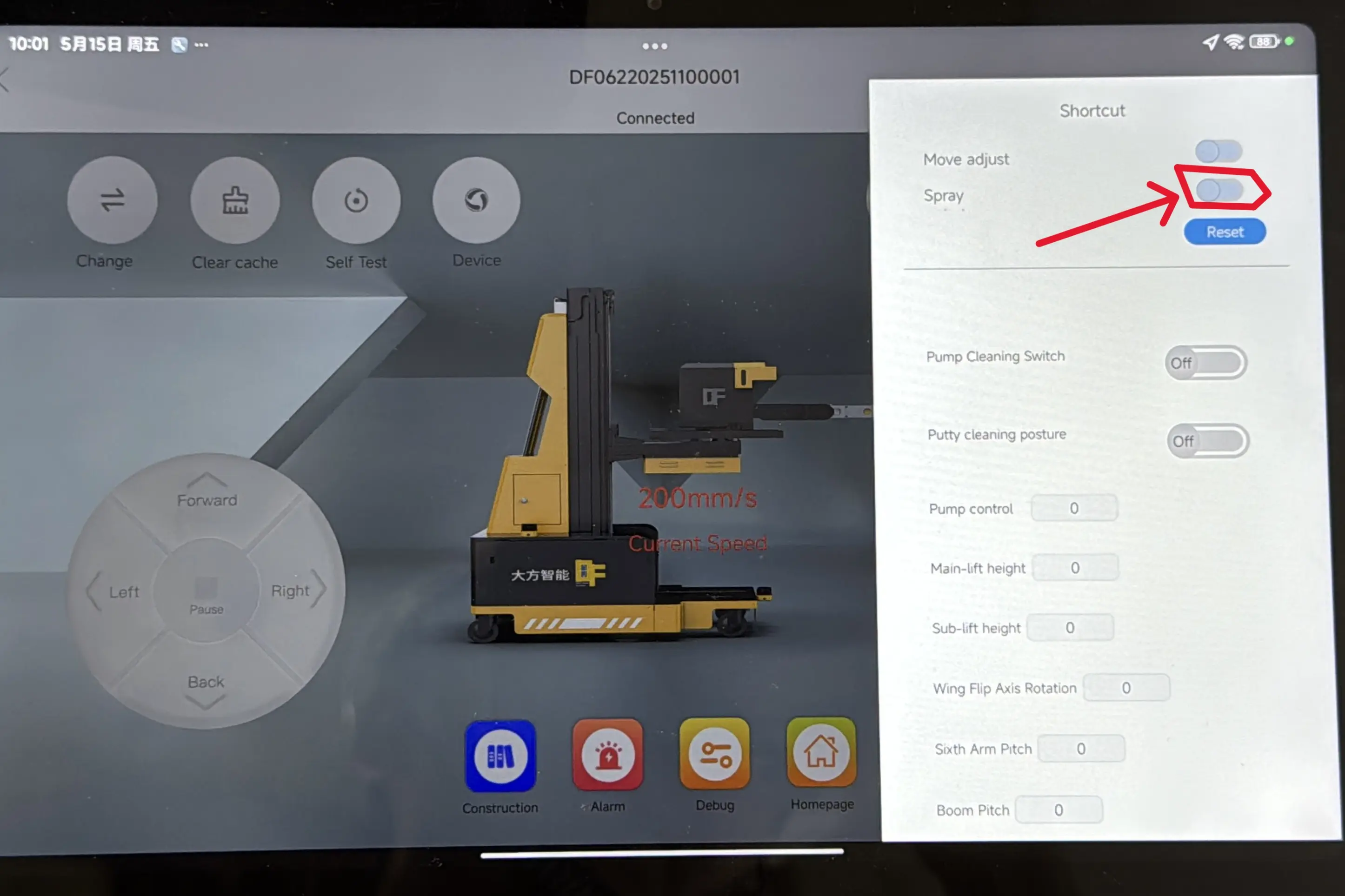

Cleaning/ Discharge Control on Application for Robot

|700x466

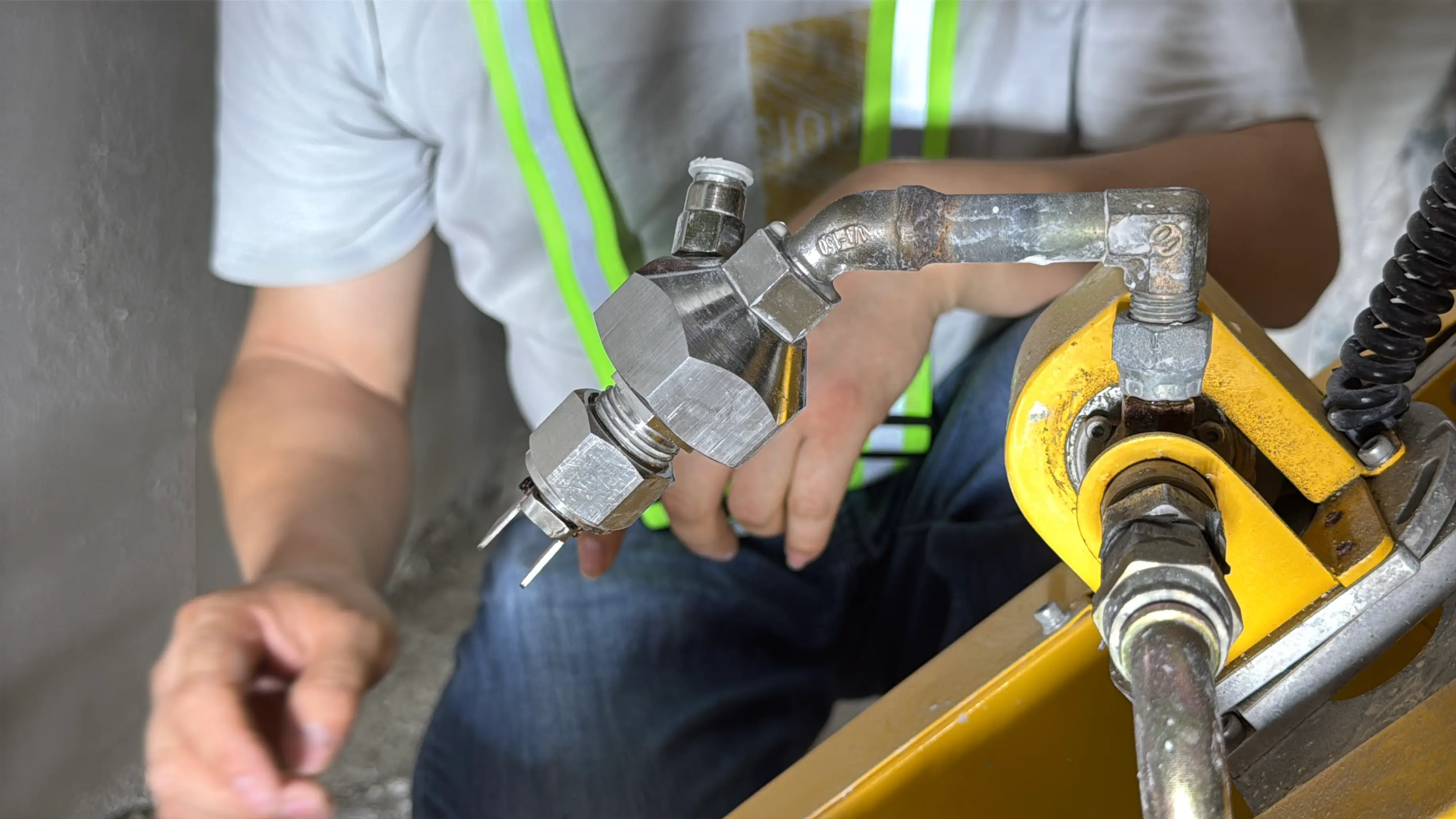

Fitting Spray Head and Switching Auto pumping mode

|547

Switching Auto mode on Material Feeder

Checking Air pressure gauge Electiric Meter Supply

Control on Application for starting operation

Ensure to go back to home page on application to prevent accidental clicking

After Putty Work Procedures

Disconnect the Air Pipe and Putty Pipe from the robot

Cleaning the Putty Spray Head

Cleaning out the putty with water after operation (same procedure)
